Work Order Lifecycle & Statuses
Complete status flow from creation to closure
Every work order follows a lifecycle. Understanding each status is key to effective maintenance management.
Status Definitions
OPEN
Created but work not started. Technician notified.
SCHEDULED
Planned for a specific date by a planner. Shows on the calendar; requires the work_orders:schedule permission. Optional — you can also start work directly from Open.
IN_PROGRESS
The technician is working on it; FreeMaint records when work started. If work was started by mistake, or needs to go back to the backlog before being reassigned, use "Back to Open" on the status stepper — the original start time is kept. Moving a work order backward, and reopening a completed one, needs its own permission, "Move a work order backward" (work_orders:revert_status), granted by default to every role that can edit work orders. To stop a role rewinding work, an Admin unticks that box at Organization > Roles: the button then disappears for that role instead of failing, and forward moves are untouched.
ON_HOLD
Paused — waiting for parts, approval, or external factors.
COMPLETED
Work done. Ready to close. Manager validation is optional unless your company enabled it in Workflow Settings.
VALIDATED
Manager approved. validatedBy and validatedAt recorded.
CLOSED
Fully resolved and archived. Costs finalized. Requires the "work_orders:close" permission. Closing is reversible: the same permission reopens the work order to In progress if it was closed too early.
CANCELLED
Cancelled before completion.
Typical Flow
- Create (OPEN) → Technician starts (IN_PROGRESS)
- Optional: a planner schedules it for a date (OPEN → SCHEDULED) before work begins.
- If parts needed: pause (ON_HOLD) → resume (IN_PROGRESS), or “Reschedule” it for a new date (ON_HOLD → SCHEDULED)
- Work done (COMPLETED) → Close (CLOSED). Optional validation step in between if configured.
Tip
Tip
Tip
Tip
Tip
Updating Asset Status from Work Orders
From the Start Work and Mark Complete dialogs, you can update the asset's operational status atomically with the WO transition — no need to navigate to the Asset module.
Operational states explained
Operational
Running normally and performing its function. Baseline state — completing a work order with 'No change' auto-resets the asset here.
Degraded
Still running but at reduced capacity or performance (ISO 14224 'degraded failure'). In OEE this is a performance loss, so it does not open downtime.
Down
Completely out of operation, unable to perform its function (ISO 14224 'critical failure'). Starts downtime tracking and counts as an availability loss.
Maintenance
Intentionally taken offline for a usually planned intervention — when you removed the asset from production to work on it, not an unexpected breakdown.
When closing a work order, leaving 'No change' lets the system auto-reset the asset from DOWN/DEGRADED/MAINTENANCE to OPERATIONAL. Override only when the asset is not fully repaired.
Filtering work orders
On the Work Orders list, use the "Filter by date" control to narrow the list to a date range. First choose which date to filter on — Due Date, Completed Date, Closed Date, or Created Date — then pick the range. The quick presets follow the date you picked: past windows such as "Last 7 days" for Completed, Closed and Created dates, and forward windows such as "Next 7 days", "This month" or "This year" (January 1st to December 31st) for Due Date, since a due date describes work still ahead of you. For example, to see everything closed last week, set the field to "Closed Date" and choose "Last 7 days". You can also filter by maintenance type (corrective, preventive, and so on) with the "Maintenance type" dropdown. When the date field is set to Due Date, a second dropdown lets you choose between "Any due date", "With a due date" and "No due date". "No due date" isolates work you deliberately leave unscheduled so it never shows up as overdue; it is mutually exclusive with a date range, so choosing it clears the range. Sorting has its own two controls: the "Sort by" dropdown picks the column, and the arrow button next to it shows and flips the direction (ascending or descending). Each column starts in its natural direction — due dates soonest first, creation and completion dates most recent first — and your choice is remembered. Every active filter appears as a removable chip and is kept in the URL, so you can bookmark or share the view. This filtering is available on every plan, including the free Core plan — a paid plan is only needed to export the filtered list.
Combining Overdue with a status
“Overdue” is a due-date filter, placed with the date filters, not a status: it means “still active and past its due date”. Combine it with statuses: “Overdue” plus In progress shows late work someone has already started. The finished statuses are greyed out while it is on, because a finished work order cannot be overdue. Filters travel in the page URL, so a view can be bookmarked or shared.
Work orders completed late
A work order finished after its due date shows “Completed late” with the number of days late, in grey, on the work order and in the list. The day counts in your company’s time zone, with the same rule as the on-time rate in analytics. To list them, click “Completed late” next to “Overdue” in the date filters. Nothing ever prevents completing a late work order or inspection.

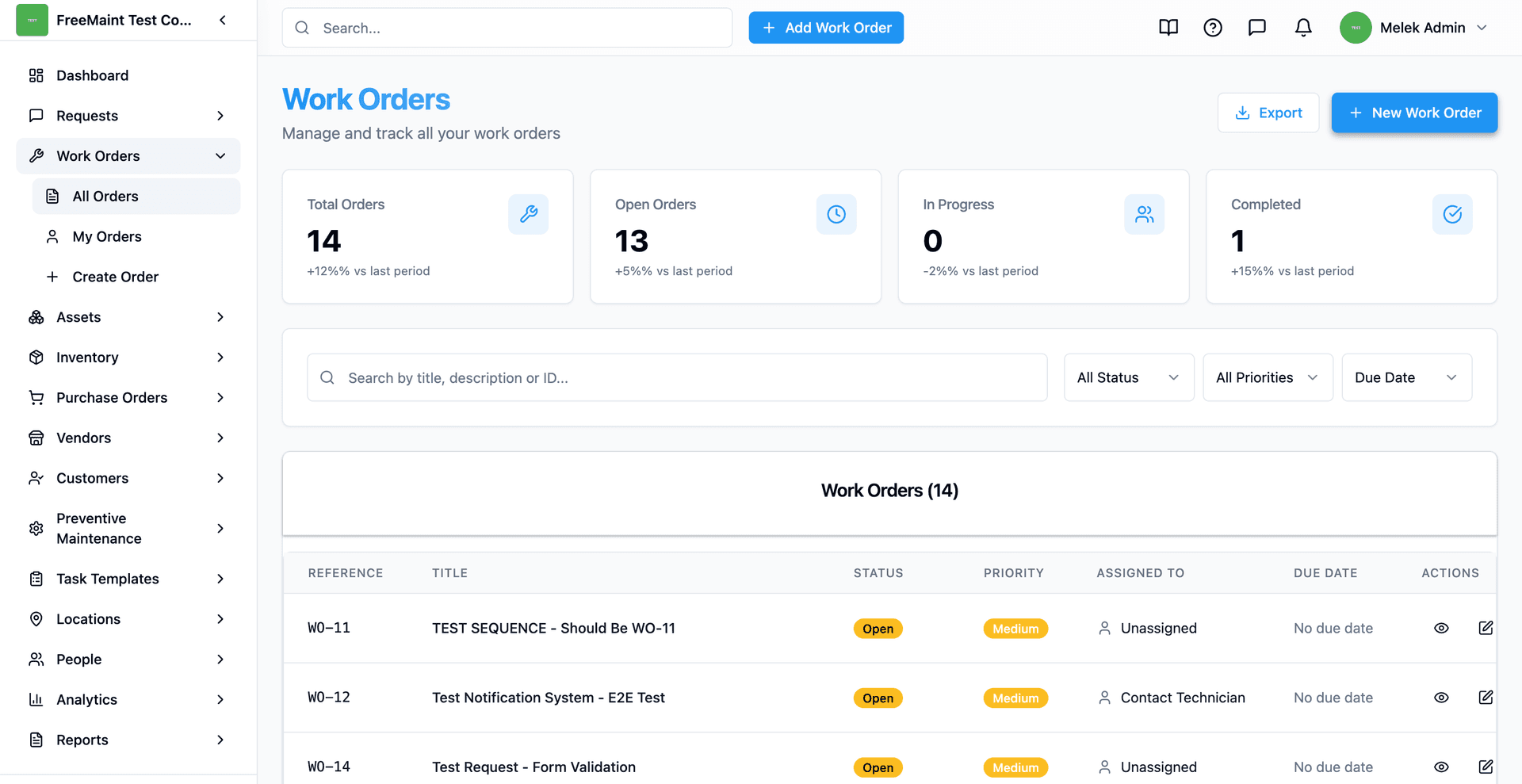

Making the list fit your screen
The Work Orders list opens with a row of summary cards and a filter bar, and both can be trimmed down. Each choice is remembered on your own account and changes nothing for anyone else. Use the "Summary cards" button beside the cards to untick the ones you never read, or hide them all — the cards are only shortcuts, so the Status dropdown still reaches every status, Overdue included. The filter bar keeps Search, Status, Priority and "Assigned to" in view and folds the rest — Asset, Location, Category, Failure category, Team, Maintenance type and the date controls — behind the "More filters" button. A number on that button says how many of the folded filters are narrowing the list right now, and every active filter still shows as a removable chip under the bar.
Validating from an email link
If your workflow asks the requester to validate a completed work order, they receive an email with a link and can sign off without an account — which matters, because a person who reported a fault by scanning a QR code does not have one. The link works for 14 days, once. The e-mail also offers "The work is not done": the requester gives a reason, the work order goes back to in progress, its creator, assignees and watchers are notified, and the reason is kept in its status history.
